Facts register.

Every figure used on this site, with its status, the date it is current as of, and a link to its primary source. Updated Sep 8, 2026. Where a later SEC filing differs, the filing controls.

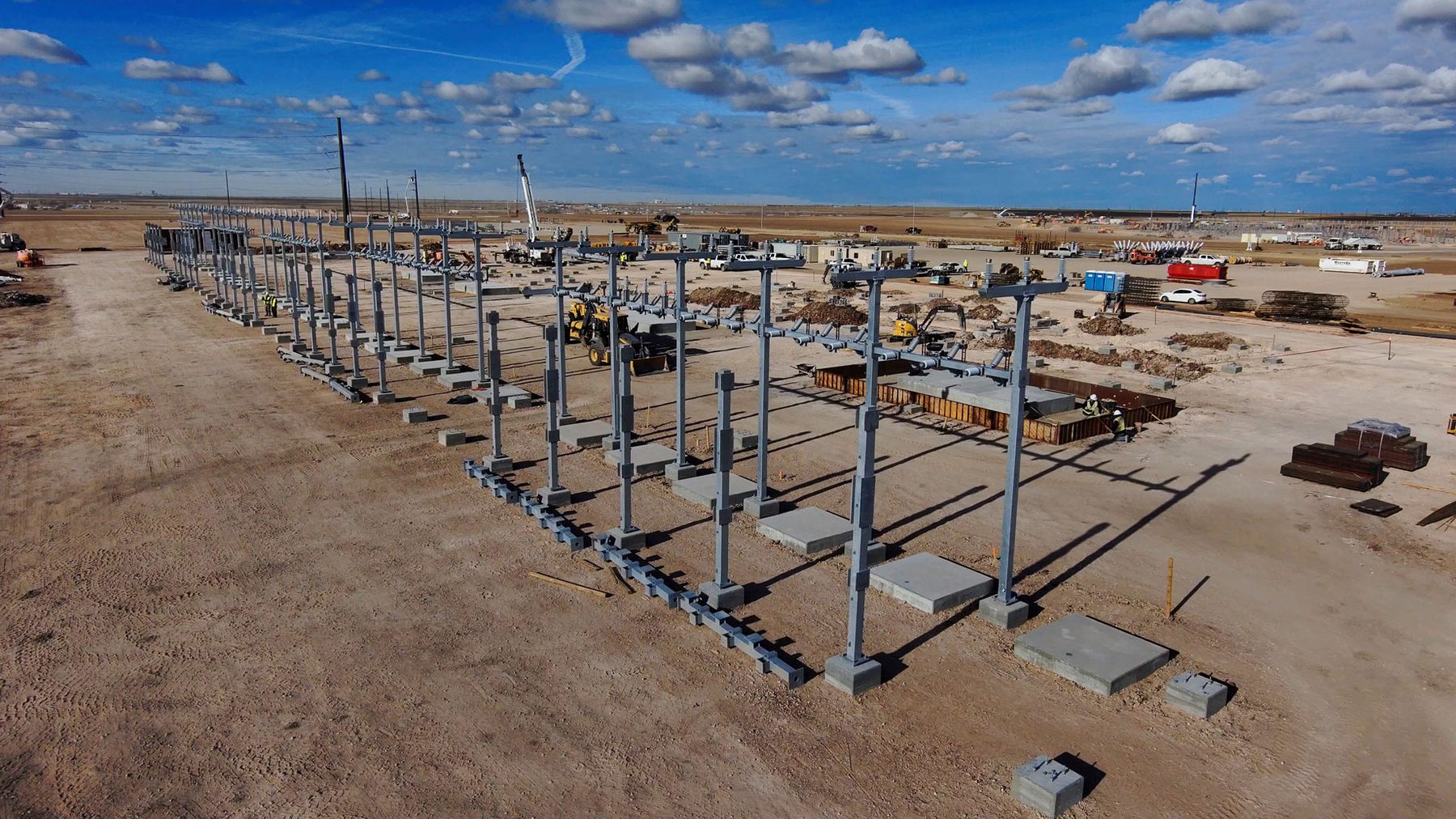

Substation steel, Carson County, February 2026

Scope

How the register is used.

Every figure is recorded once with the disclosure it came from, and the pages read from the register rather than restating it.

Register as of Sep 8, 2026 · showing 44 of 44

Land

MetricValueStatusAs ofPrimary source
Under the Texas Tech ground lease todayThe 99-year ground lease was signed on May 14, 2025 for 5,769 acres. A first amendment executed in August 2025 set the leased site at approximately 4,523 acres, with a 713-acre tract to be added upon transfer from a federal agency to Texas Tech University, for approximately 5,236 acres in total. Groundwater leases covering approximately 5,227 acres are held separately and are not part of this figure.~4,523acresContracted (disclosed)Jun 30, 2026Fermi Inc. Form 10-Q for the quarter ended June 30, 2026 ↗Aug 14, 2026
Pending transfer from a federal agencyA 713-acre tract to be added to the Texas Tech ground lease upon transfer from a federal agency to Texas Tech University, taking the leased site to approximately 5,236 acres.713acresApplication pending (forward-looking)Jun 30, 2026Fermi Inc. Form 10-Q for the quarter ended June 30, 2026 ↗Aug 14, 2026
Project Matador site, in the aggregateThe Form 10-Q for the quarter ended June 30, 2026 states that the site includes approximately 5,236 acres held or to be held under a long-term lease with the Texas Tech University System and, together with additional acreage acquired, under contract, or subject to options to purchase, is expected to encompass approximately 8,400 acres in the aggregate. The aggregate figure depends on the closing of pending acquisitions and the exercise of purchase options. Acreage figures published before August 2026, including the 5,769 acres of the original Texas Tech ground lease and the 5,800 acres cited in 2025 coverage, describe earlier stages of the same site and have been superseded.~8,400acresReported (disclosed)Jun 30, 2026Fermi Inc. Form 10-Q for the quarter ended June 30, 2026 ↗Aug 14, 2026

Capacity and permits

MetricValueStatusAs ofPrimary source
Natural gas permitted by TCEQOne Texas Commission on Environmental Quality clean-air permit covering ~6 GW; final approval Feb 25, 2026 after preliminary approval in Nov 2025.~6GWPermitted (disclosed)Feb 25, 2026Fermi America secures final 6 GW clean-air permit from TCEQ (release) ↗Feb 25, 2026
Additional TCEQ application pendingSecond clean-air permit application for the east side of the campus. Filed; not approved. No assurance it will be granted.~5GWApplication pending (forward-looking)Mar 27, 2026Fermi America files second clean-air permit application (~5 GW) with TCEQ (release) ↗Mar 27, 2026
Private-grid generation plannedCompany plan for Project Matador at full build. Capacity beyond the ~6 GW already permitted is subject to additional permits, financing, interconnection capacity and land acquisition, including the second ~5 GW TCEQ application filed Mar 27, 2026 and pending land closings.~17GWPlanned (forward-looking)Jun 30, 2026Fermi Inc. Form 10-Q for the quarter ended June 30, 2026 ↗Aug 14, 2026
Generation equipment landed in TexasSix Siemens Energy SGT-800 units (arrived Feb 2026) and three Siemens Energy SGT6-5000F units (arrived Jul 2026), as reported by the company. Landed equipment is not yet installed or generating.~2.2GWLanded in Texas (disclosed)Aug 13, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026
Hillcore Energy Capital power centerFramework alliance (Aug 11, 2026): a build-own-operate-transfer power center (~2.5 GW gas plus ~100 MW solar and storage) with Fermi as anchor offtaker under a 20-year PPA and no Fermi capital expenditure. Definitive agreements were pending as of the Q2 2026 release.~2.6GWPlanned (forward-looking)Aug 13, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026
Grid supply via SPS / Xcel EnergyElectric service agreement with Southwestern Public Service (an Xcel Energy subsidiary); initial energization of 86 MW targeted first. Not company-owned generation.up to 200MWContracted (disclosed)Aug 13, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026

Equipment

MetricValueStatusAs ofPrimary source
Siemens Energy SGT-800~300 MW simple-cycle (Phase One). Bathtub excavation complete for all six power islands as of Q2 2026. Six further SGT-800s are financed for 2028 delivery (CSG Investments facility).6Landed in Texas (disclosed)Aug 13, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026
Siemens Energy SGT6-5000FF-class units, up to ~728 MW simple-cycle (Phase Two). One unit is on the campus in Carson County; two are in transit from the Port of Houston. TSK engaged for early works and fast-start engineering.31 onsite, 2 enroute (disclosed)Sep 15, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026
GE Frame 6B~114 MW simple-cycle. Three units, on the campus in Carson County.3Onsite (disclosed)Sep 15, 2026Fermi Inc. Annual Report on Form 10-K for fiscal 2025 ↗Mar 30, 2026
GE TM2500 mobile unitsApproximately 132 MW of mobile aeroderivative generation under contract.7Contracted (disclosed)Dec 31, 2025Fermi Inc. Annual Report on Form 10-K for fiscal 2025 ↗Mar 30, 2026

Schedule

MetricValueStatusAs ofPrimary source
Initial commercial power, next ~6 monthsCompany guidance of "about 200 megawatts of initial commercial power over the next six months" from Aug 13, 2026, working with Xcel Energy toward 200 MW on site. Forward-looking.~200MWTarget (forward-looking)Aug 13, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026
First on-site generation to anchor tenantManagement guidance on the Q2 2026 call: first ~210 MW available July 1, 2027, ~640 MW nameplate by Q4 2027. The Form 10-Q states commercial operations are targeted to commence in 2027. Forward-looking; schedules can change.Jul 1, 2027Target (forward-looking)Aug 13, 2026Second Quarter 2026 earnings call (management guidance) ↗Aug 13, 2026
Within 18 to 24 monthsCompany guidance: "about 1.5 GW over the next 18 to 24 months" from Aug 13, 2026. Forward-looking.~1.5GWTarget (forward-looking)Aug 13, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026
On-site generation within ~30 monthsCompany statement that the Hillcore alliance would double planned on-site generation to ~4.8 GW within approximately 30 months; depends on definitive agreements, financing and construction.~4.8GWTarget (forward-looking)Aug 13, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026

Anchor tenant

MetricValueStatusAs ofPrimary source
TensorWave Phase 1 facility powerBinding lease with TensorWave, an AI cloud infrastructure provider. Initial term of 15 years after the final delivery phase, plus two five-year renewal options; phased delivery beginning in the second half of 2027.222MWContracted (disclosed)Aug 10, 2026Fermi announces binding lease agreement with TensorWave (release) ↗Aug 10, 2026
Contracted revenue, Phase 1 initial termTotal contracted revenue over the 15-year initial term for Phase 1 as stated by the company; undiscounted and assuming full delivery and performance. Expansion options could take the facility to 650+ MW across three phases.~$6.5BContracted (disclosed)Aug 10, 2026Fermi announces binding lease agreement with TensorWave (release) ↗Aug 10, 2026
With expansion options exercisedTwo expansion options across three phases; options are the tenant’s to exercise.650+MWPlanned (forward-looking)Aug 10, 2026Fermi announces binding lease agreement with TensorWave (release) ↗Aug 10, 2026

Nuclear

MetricValueStatusAs ofPrimary source
Westinghouse AP1000 units, NRC application docketedCombined License Application Parts 1 and 2 submitted Jun 17, 2025 and docketed by the NRC Sep 5, 2025 (dockets 052-00051 to 052-00054). Docketing is acceptance for review, not a license. Part 3 targeted by Dec 31, 2026; the NRC schedules a Final EIS for Dec 2026.4Application pending (forward-looking)Sep 5, 2025U.S. NRC, Fermi America Combined License Application (PMN Units 1 to 4) ↗Updated Aug 27, 2026
Planned nuclear capacityCompany plan for the nuclear units at full build. The Combined License Application is before the NRC; no construction or operating license has been issued.~6GWPlanned (forward-looking)Jun 30, 2026Fermi Inc. Form 10-Q for the quarter ended June 30, 2026 ↗Aug 14, 2026

Site and infrastructure

MetricValueStatusAs ofPrimary source
City of Amarillo water, at twice the standard rateWater supply agreement approved by Amarillo City Council Oct 28, 2025. Fermi funds all connection infrastructure. A non-binding framework to scale supply and 30-year groundwater leases are described in the Form 10-K; larger figures are not contracted.up to 2.5MGDContracted (disclosed)Oct 30, 2025City of Amarillo, Fermi project water supply agreement ↗Oct 30, 2025
Natural-gas supply arrangement (Energy Transfer)Supply via the Transwestern interconnect; ~4.6 to 4.7 miles of on-site high-pressure pipeline installed.~300,000MMBtu/dayContracted (disclosed)Dec 31, 2025Fermi Inc. Annual Report on Form 10-K for fiscal 2025 ↗Mar 30, 2026
AI data center capacity at full build-outCompany plan; depends on tenant demand, financing, permits and construction.up to ~15M sq ftPlanned (forward-looking)Jun 30, 2026Fermi Inc. Form 10-Q for the quarter ended June 30, 2026 ↗Aug 14, 2026
Fencing / water line / gas line installedCompany-reported site works as of the second quarter of 2026, plus ~261 acres (~11.4 million sq ft) of site preparation.11.3 / 7.2 / 4.6milesReported (disclosed)Jun 30, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026
Invested in site build-out to dateProperty, plant and equipment, net of $1,547.9 million at June 30, 2026.$1.5B+Reported (disclosed)Jun 30, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026

Financing and results

MetricValueStatusAs ofPrimary source
IPO gross proceeds, priced Sep 30, 2025 at $21.0037,375,000 shares including the full over-allotment option. Nasdaq trading began Oct 1, 2025; London Stock Exchange trading Oct 2, 2025.$784.9MReported (disclosed)Oct 3, 2025Form 8-K (closing of initial public offering) ↗Oct 3, 2025
5.00% convertible senior notes due 2031Rule 144A offering closed July 2026; net proceeds ~$416.8 million after capped-call transactions. Conversion rate 105.0862 shares per $1,000 (~$9.52). Not an offer of securities.$431.25MReported (disclosed)Jul 15, 2026Form 8-K (5.00% Convertible Senior Notes due 2031) ↗Jul 15, 2026
MUFG non-recourse turbine facility$444.9 million drawn at June 30, 2026 (Form 10-Q).$500MContracted (disclosed)Jun 30, 2026MUFG $500 million equipment loan (release) ↗Feb 10, 2026
Keystone / Cape high-voltage equipment facilityThe Form 10-K describes a $120 million facility with a $100 million upsize option; the announcement headlines the $200 million total. $77.3 million was drawn at June 30, 2026.$120MContracted (disclosed)Jun 30, 2026Keystone National Group / Cape Commercial Finance equipment facility (release) ↗Feb 24, 2026
CSG Investments facility, six SGT-800s for 2028Equipment facility for a second tranche of six Siemens Energy SGT-800 units.$165MContracted (disclosed)Mar 27, 2026Fiscal 2025 results release (CSG $165M SGT-800 facility) ↗Mar 30, 2026
Yorkville promissory-note commitment (undrawn)Committed but undrawn as of June 30, 2026.$156.25MContracted (disclosed)Jun 30, 2026Fermi Inc. Form 10-Q for the quarter ended June 30, 2026 ↗Aug 14, 2026
Cash and restricted cash, June 30, 2026Before ~$416.8 million of net proceeds from the July 2026 convertible notes. The Form 10-Q discusses liquidity, including going-concern considerations management concluded were alleviated by its plans.$91.7MReported (disclosed)Jun 30, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026
Net loss, Q2 2026Pre-revenue. Net loss of $214.5 million for the six months ended June 30, 2026, including significant non-cash share-based compensation.$25.8MReported (disclosed)Jun 30, 2026Second Quarter 2026 results release (Form 8-K, Ex. 99.1) ↗Aug 13, 2026
Shares of common stock outstandingPer the Form 10-Q cover; also the total voting rights figure notified via RNS on Jul 23, 2026.640,467,348Reported (disclosed)Aug 10, 2026Fermi Inc. Form 10-Q for the quarter ended June 30, 2026 ↗Aug 14, 2026

Community

MetricValueStatusAs ofPrimary source
Permanent jobs at full build-outCompany estimate (roughly 3,000 in data-center operations). Not an audited figure and not contained in an SEC filing; depends on full build-out.~5,400Company estimate (forward-looking)Sep 1, 2026Fermi America newsroom, “Community Questions” (company estimate, not an SEC filing) ↗Sep 1, 2026
Construction jobs per day at peakCompany estimate; subject to change with the construction schedule.10,000+Company estimate (forward-looking)Sep 1, 2026Fermi America newsroom, “Community Questions” (company estimate, not an SEC filing) ↗Sep 1, 2026

Corporate

MetricValueStatusAs ofPrimary source
Headquarters1845 Woodall Rodgers Freeway, Suite 1100, Dallas, TX 75201. The company maintains a project office in Amarillo, Texas.Dallas, TexasReported (disclosed)Aug 31, 2026Form 8-K (annual meeting date, headquarters, Audit Committee) ↗Aug 31, 2026
Chief Executive Officer (effective Aug 11, 2026)Independent director since the IPO; former Chairman and CEO of CH2M HILL and CEO of TerraPower. Resigned from the Audit Committee on appointment.Lee McIntireReported (disclosed)Aug 14, 2026Form 8-K (appointment of Lee McIntire as Chief Executive Officer) ↗Aug 14, 2026
Inaugural annual meeting of stockholdersRecord date August 31, 2026. Proxy materials will be filed with the SEC and posted under Investor Relations when available.Oct 30, 2026Reported (disclosed)Aug 31, 2026Form 8-K (annual meeting date, headquarters, Audit Committee) ↗Aug 31, 2026
Reported (disclosed)Landed in Texas (disclosed)Onsite (disclosed)Enroute (disclosed)Permitted (disclosed)Contracted (disclosed)

Disclosed facts as of the date shown, taken from SEC filings, regulator records or company releases.

Application pending (forward-looking)Planned (forward-looking)Target (forward-looking)Company estimate (forward-looking)

Forward-looking statements that depend on permits, financing, construction, counterparties and market conditions, and may not be realized. Every value is superseded by the company’s subsequent SEC filings.

Concept site

Concept site. This is an independent design study of how Fermi America could present itself online. It is not the official Fermi America website and is not published by Fermi Inc. Official sites: fermiamerica.com and investor.fermiamerica.com.

Fermi, doing business as Fermi America, is developing Project Matador, a private power grid and AI data-center campus in Carson County, Texas, near Amarillo.

Listings
Nasdaq: FRMI · LSE: FRMI
ISIN
US3149111086

Offices

Headquarters · 1845 Woodall Rodgers Fwy, Suite 1100
Dallas, Texas 75201
Project office · 620 S. Taylor St., Suite 301, Amarillo, Texas 79101
