Business

Fermi’s business.

Fermi leases powered data-center capacity. One lease is binding. The company is pre-revenue until that facility is delivered.

222MW
First binding lease, TensorWave, August 2026
~$6.5B
Contracted revenue, undiscounted, from the TensorWave lease
$1.5B+
Invested in the site to date, June 30, 2026
$431.25M
5.00% convertible notes due 2031
Business model

What Fermi owns and what it leases.

Fermi leases land, buys turbines, builds shells and signs leases. It sells neither electricity nor compute, and revenue begins when a facility is delivered.

  • What a tenant pays forA building, and the generation that runs it, under one lease with one landlord. The TensorWave lease implies ~$1.95 million per megawatt-year, undiscounted: ~$6.5 billion divided by 222 MW and by the 15-year initial term.
  • What Fermi carriesLand, permits, turbines, switchyard and shell, funded ahead of revenue. Property, plant and equipment, net, stood at $1,547.9 million at June 30, 2026.
Permits and licensing

Regulatory status.

The TCEQ made one clean-air permit final in February 2026, covering ~6 GW of natural gas, and is reviewing a second application for ~5 GW filed in March 2026. The NRC docketed a Combined License Application for four Westinghouse AP1000 units in September 2025 and schedules a Final Environmental Impact Statement for December 2026; docketing is acceptance for review, not a license, and no unit may be built or operated until the NRC issues one.

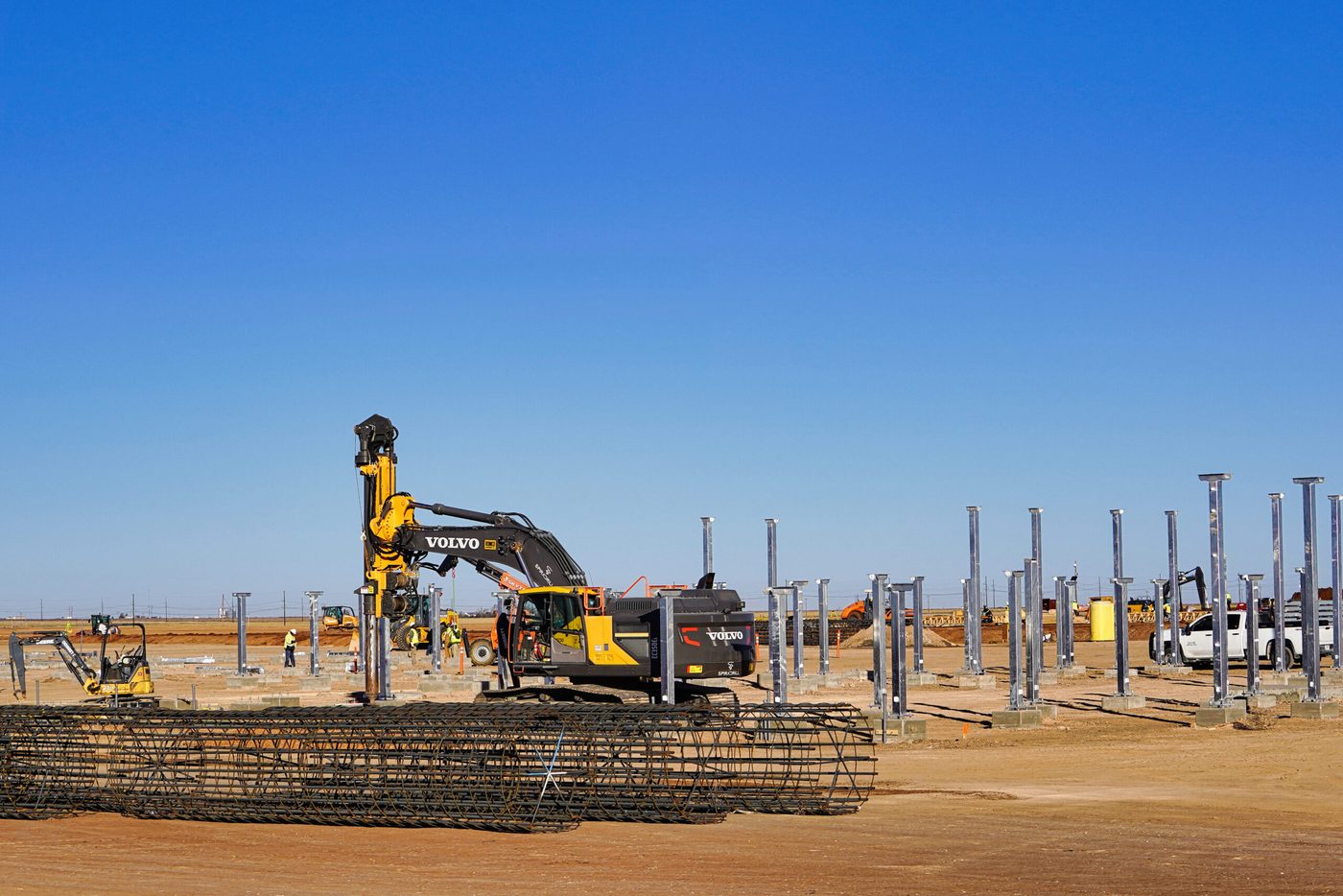

Construction

Work completed on site.

Reported for the second quarter of 2026. Nothing generates yet.

  • 11.3 milesPerimeter fencing installed.
  • 7.2 milesWater line installed.
  • 4.6 milesHigh-pressure gas line installed.
  • ~261 acresSite preparation completed within the campus, ~11.4 million square feet.
Project Matador site, Carson County
Targets

Schedule guidance.

Management guidance from August 2026, forward-looking and not assured.

  • ~200 MW, within six monthsInitial commercial power, from the grid.
  • ~210 MW, July 1, 2027First on-site generation to the anchor tenant, with ~640 MW nameplate by the fourth quarter of 2027.
  • ~1.5 GW, 18 to 24 monthsOn-site generation.
  • ~4.8 GW, ~30 monthsOn-site generation, if the Hillcore power center reaches definitive agreements and is built.
Capacity scheduleGuidance, August 2026

Generation capacity over time.

~17 GW~11 GW~4.8 GW~1.5 GWEarly 20272028~20292030sFull build~200 MW · initial commercial power (target)~1.5 GW · 18 to 24 months (target)~4.8 GW · ~30 months with Hillcore (target)~17 GW planned at full build (subject to permits)Solid: landed or contracted. Dashed: target or planned (Q2 2026 results and call, Aug 13, 2026). Forward-looking.
Capital

How the build is financed.

Non-recourse equipment facilities finance the turbines and high-voltage gear. The October 2025 offering and the July 2026 convertible notes fund the balance. Cash and restricted cash stood at $91.7 million on June 30, 2026, before ~$416.8 million of net note proceeds. Management identified conditions raising substantial doubt about the ability to continue as a going concern and concluded that its plans alleviate that doubt; the Form 10-Q sets out the analysis.

$500M
MUFG turbine facility; $444.9M drawn at June 30, 2026
$120M
Keystone and Cape facility, plus a $100M upsize option
$165M
CSG Investments facility, six SGT-800 units for 2028
$416.8M
Net proceeds from the July 2026 notes
Equipment and corporate financing providersMUFG·Keystone National Group and Cape Commercial Finance·CSG Investments·Yorkville Advisors·5.00% convertible senior notes due 2031
